Construction Progress
- Concession signed
- 12 March 2024
- Construction commenced
- 2 August 2024
- Scheduled completion
- 2 August 2027
- Contract duration
- 1,095 days
- Equipment on site
- 284
- Contract variation
- Nil
Interchange progress
Select a structure to view its proposed design.
Interchange progress figures are sourced from the Progress report, 7 October 2026.
Works in progress
Earthworks
Earthworks include site clearance, excavation, replacement of unsuitable materials, rock filling, engineered fill and road formation along the Section 1 corridor.
- Site clearance76 hectares
- Topsoil cutting and disposal23,150 m³
- Cut-to-fill / borrow material650,241 m³
- Unsuitable-material replacement174,789 m³
- Rock filling238,375 m³
Cumulative quantities recorded to date in the May 2026 report.
Concrete and structural works
Concrete and reinforcement quantities recorded to date in the May 2026 report.
- Plain concrete1,902 m³
- Reinforced concrete17,772 m³
- Reinforcement steel4,186 tonnes
Drainage and culverts
Box and bridge culverts carry storm flows clear of the carriageway. Status categories are shown as reported; they are not reconciled into a single total to avoid implying a precision the report does not state.
- Box culverts in the project20
- Commenced18
- Completed11
- Ongoing6
- Outstanding2
Three bridge / big culverts had commenced; all three were ongoing as of the report.
Footbridges
Ten pedestrian footbridges / crossing points form part of the Section 1 scope. Construction has started at several locations, with the most advanced at CH 12+350, reported at 72%.
View reported footbridge statuses
| Chainage | Reported status |
|---|---|
| CH 0+080 | 20% |
| CH 0+853.6 | Not yet reported |
| CH 4+490 | Not yet reported |
| CH 6+300 | 57% |
| CH 8+050 | 25% |
| CH 8+885 | 44.5% |
| CH 9+920 | 55% |
| CH 12+350 | 72% |
| CH 16+200 | 34% |
| CH 18+295 | 7% |
Recent construction activity
What has been built recently along the corridor, in pictures.

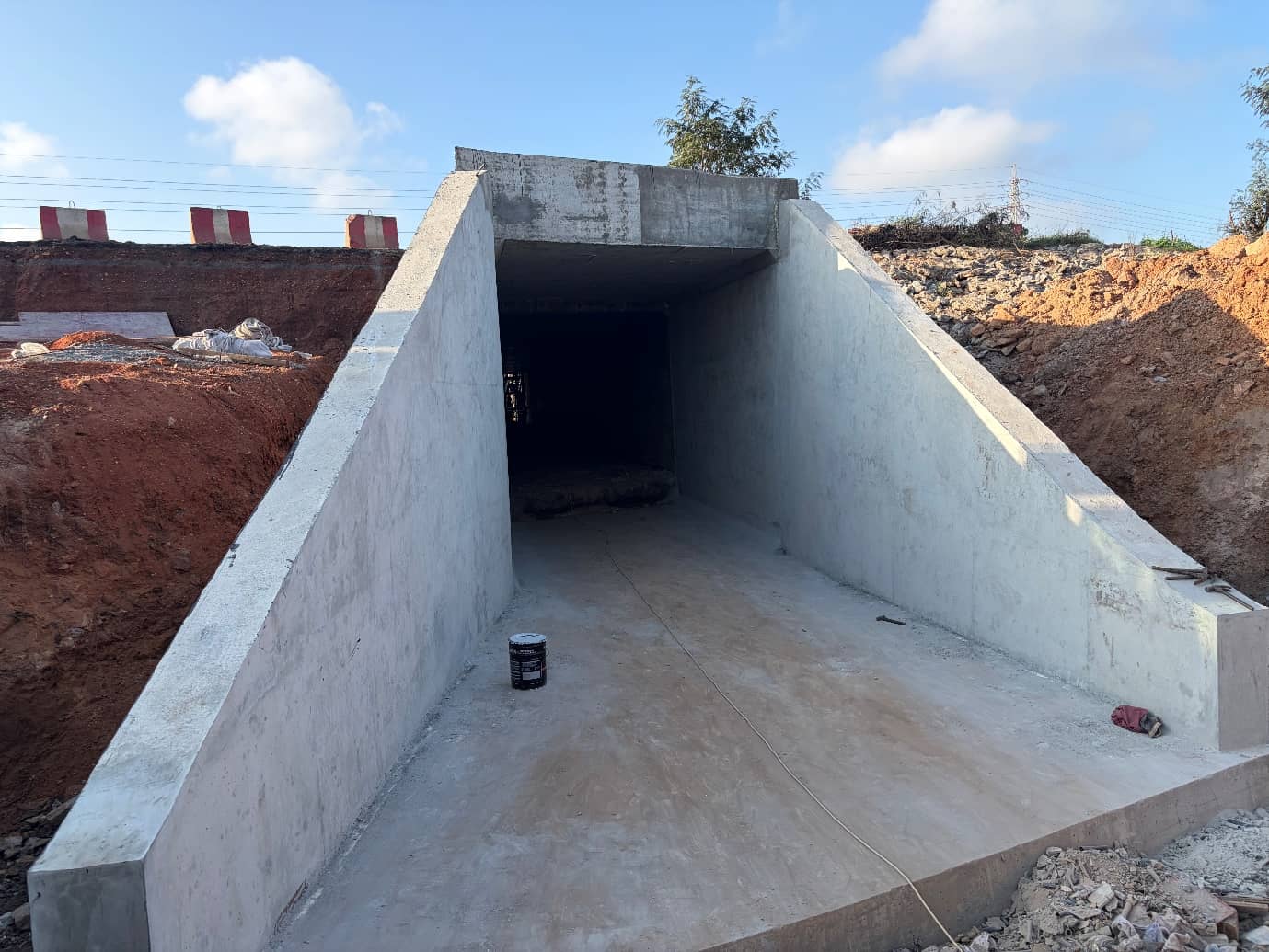

Underpass structure completedCommunity 18 Interchange

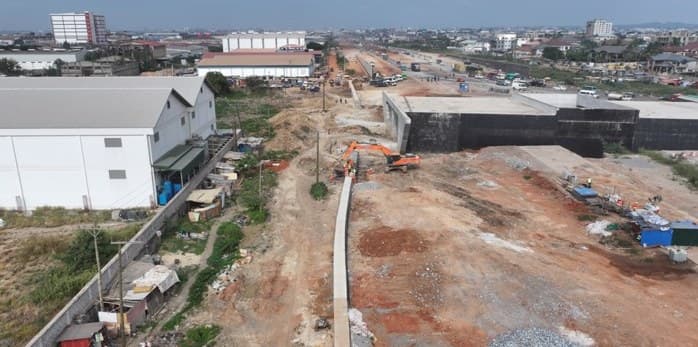

Traffic diversion walls builtTeshie Link Interchange
Bridge beams cast and placedAlong the Section 1 corridor
Pedestrian footbridge going upNear Km 8+050

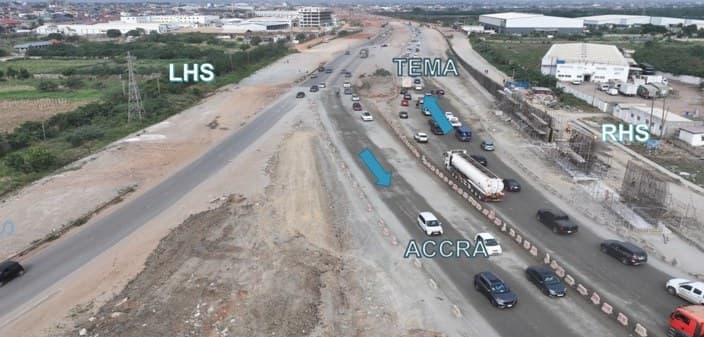

Retaining walls under constructionNear Km 12+120
New road foundation being laidBetween Km 7+600 and Km 8+340
This month and next
Work done for the month of September

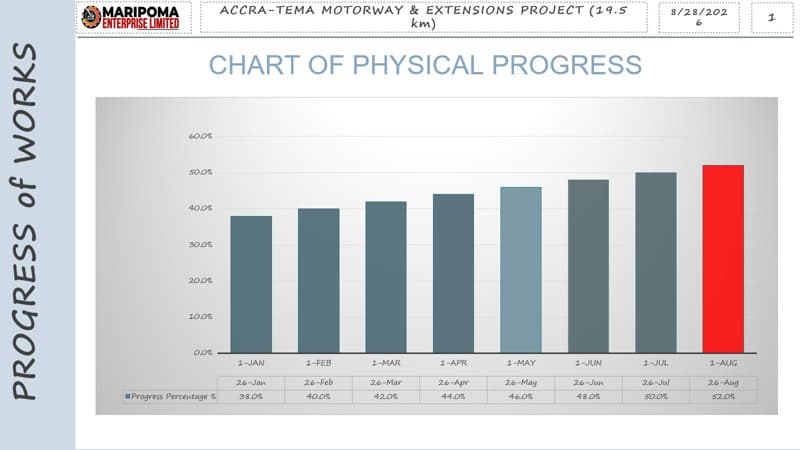

- Physical progress 53%, up from 52% in August.
- Traffic diversion and footing walls constructed at Lachibi Interchange (km 16+200)
- T-beam installation for Bridge at km 10+873 (LHS*RHS)
- Casting of surface concrete and approach slab for Bridge at km 10+873 (LHS*RHS)
- Construction of piles and pier caps for Bridge at km 13+745-LHS
- Formwork and reinforcement for Abutment at km 13+745 Bridge-LHS
- Construction of U-shaped ramp for Footbridge No. 5 at km 8+050 – LHS
- Formwork and reinforcement for Footbridge No. 7 at km 9+920 -RHS
- Subgrade laid between 16+600 and 18+300
- Construction of Lashibi interchange- Median section.
- U-drain construction – 1000 m
- Sub-base +crushed stone laid (0/40 mm- 2 layers) from 1+000 -5+500
Bridge and interchange completion, September 2026
| # | Bridge | Earthworks % | Structure % | Earthworks Completion | Structure Completion | Total complettion |
|---|---|---|---|---|---|---|
| 1 | Tetteh Quarshie | 5% | 95% | 0% | 95% | 95% |
| 2 | Teshie Link | 10% | 90% | 2% | 90% | 92% |
| 3 | Community 18 | 10% | 90% | 3% | 90% | 93% |
| 4 | Lashibi | 15% | 85% | 0% | 40% | 40% |
Work planned for October
- Rock filling - 70,000 m³.
- Natural gravel sub-base - 3,000 m³.
- Graded crushed stone sub-base - 2,000 m³.
- Graded Crushed Stone Base - 2,000 m³.
- Trapezoidal concrete drain - 2,000 m, and U-drain - 1,000 m.
- T–beam installation for Lachibi Interchange at km 16+200.
- Pier construction for footbridge No. 1 at km 0+000
- Piling for footbridge No. 2 at km 0+860.
- Continuous work on Footbridge No. 3 at km 4+655 ( U shaped Ramp)
- Continuous work on Footbridge No. 5 at km 8+050 (Stairs).
- Continuous work on Footbridge No. 10 at km 18+295 (Formwork and reinforcement).
Footbridge chainages — percentage complete and planned
| Nbr | Footbridges-Chainages | Percentage of previous completed work | Percentage done for September | Percentage planned for October |
|---|---|---|---|---|
| 1 | CH 0+000 | 26% | 2% | 15% |
| 2 | CH 0+860 | - | 5% | 10% |
| 3 | CH 4+655 | 3% | 2% | 10% |
| 5 | CH 8+050 | 35% | 40% | 15% |
| 6 | CH 8+885 | 45% | 50% | 10% |
| 7 | CH 9+920 | 52% | 10% | - |
| 10 | CH 18+295 | 25% | 5% | 10% |
Construction considerations
Traffic management
Construction activities can create temporary congestion. The project uses traffic-management plans, alternative routing, signage and public awareness measures.
Dust and environmental management
The report identifies dust and emissions as an environmental consideration. Mitigation measures include water spraying, equipment management and environmental monitoring.
Utilities and right-of-way coordination
Relocation of electricity and water infrastructure remains part of the construction coordination process.
Milestone timeline
- 12 March 2024Concession signed
- 2 August 2024EPC Commences36-month window begins
- September 2026Current53% completeLatest Monthly Progress Report
- 2 August 2027Scheduled completion
