The Project

The Accra–Tema Motorway and Extensions Project is a 27.7 km overall design project. Section 1 corridor — Tema Roundabout to Tetteh Quarshie Interchange — is the phase currently under construction.
The full design

The complete 27.7 km scope

The project covers three connected sections between Tema Port, Accra and its surrounding areas. Section 1 (Phase 1) is being built now; Sections 2 (Phase 2 & 3) and 3 have been designed under the same contract and form the second phase, together with the long-term operation and maintenance of the whole corridor.

Accra–Tema Motorway · N1
19.5km

Tetteh Quarshie → Tema

On completion
10 lanes
Delivery
Phase 1 · under construction
George Bush Highway · N4
5.7km

Tetteh Quarshie → Apenkwa

On completion
12 lanes
Delivery
Phase 2
Nsawam Road · N6
2.5km

Apenkwa → Neoplan

On completion
6 lanes
Delivery
Phase 2
Across the whole corridor
27.7km
Total corridor
3
Sections
5
New interchanges
2
Remodelled interchanges
30year
Concession Term
2
Delivery phases

Explore the corridor

Move along the 27.7 km corridor to see its three sections, their boundaries and the interchanges. Select any point for its detail; interchange positions are approximate, drawn from reported chainage and pending confirmation.

NeoplanTema
N6N4N1

Drag along the corridor, or select a point below. Interchange positions are approximate (from reported chainage) and pending confirmation.

Interchange · approx.

Tetteh Quarshie

70% complete
Chainage
approx. CH 0+500
Section
Accra–Tema Motorway · N1
Position
8.7 km (approx.)

Reported activity (May 2026): T-beam installation and joint concreting works

Proposed design

A 27.7 km design, one section under construction

The full design project spans three sections. Section 1 — the 19.5 km Accra–Tema Motorway corridor — is the section currently being built, and Sections 2 and 3 form part of the wider design project.

Section 1 · N1

Accra–Tema Motorway

19.5km

Tetteh Quarshie → Tema · under construction

Section 2 · N4

George Bush Highway

5.7km

Tetteh Quarshie → Apenkwa

Section 3 · N6

Nsawam Road

2.5km

Apenkwa → Neoplan

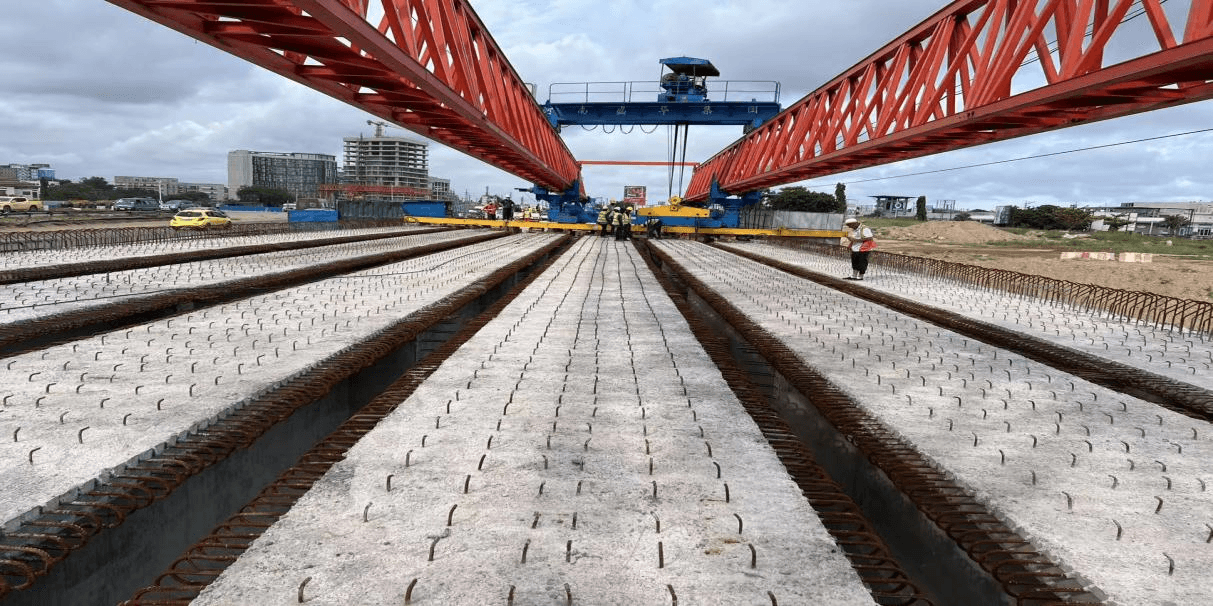

A launching gantry positioning precast T-beams over a bridge span, with reinforcement projecting from the beams

Why the motorway is being reconstructed

The Accra-Tema Motorway & Extensions PPP Project is Ghana’s first toll road public private partnership (PPP) project.

The Accra - Tema Motorway dual carriageway links Accra and the industrial city of Tema, where Ghana’s main port is located. It was opened as a freeway in 1964 under Ghana’s first president, Kwame Nkrumah. The design life of the motorway was intended for 20 years and the pavement has outlived its terminal level of serviceability with visible fatigue-cracking, joint failures and pumping under wheel load and requires reconstruction.

The project scope of the ATMP covers 27.7 km and involves an upgrade of 27.7KM of the national road network in the Greater Accra Region together with the operation and maintenance of the road, including toll road system on certain sections. The Project will be delivered in two phases, ensuring timely delivery and efficiency providing solutions to address the challenges with the freeway.

The reconstruction and extension project is intended to improve mobility and accessibility, ease congestion across the N1, N4, Liberation Road and N6 corridors, strengthen regional integration and provide safer and more reliable transport infrastructure — supporting Ghana’s broader goal of an integrated, efficient and sustainable transport system.

Increased mobility and accessibility

A rebuilt, higher-capacity corridor that moves people and vehicles more reliably across Accra and Tema.

Reduced congestion

Grade-separated interchanges and added capacity ease pressure across the N1, N4, Liberation Road and N6 corridors.

Safer pedestrian movement

Dedicated pedestrian crossing points separate people on foot from high-speed traffic.

Improved regional connectivity

Stronger links between the capital, residential and industrial communities and the Tema logistics area.

Stronger links for freight and trade

More reliable access to and from the Tema transport and logistics area for goods movement.

More durable road and drainage infrastructure

Reconstructed pavement and upgraded drainage built for the corridor's demand.

Scope of Work (Section 1)

  • Reconstruction of the Tetteh Quarshie Interchange
  • Construction of new interchanges at Teshie Link, Community 18, and Lashibi
  • Construction of 10 pedestrian crossing points
  • Enhancement of roadway traffic in the Lagos Avenue / Lagos Link area
  • Rehabilitation and widening of Liberation Road to Polo Club, with overpass

The Section 1 scope includes 10 pedestrian crossing points.
